Melbourne Builder Explains Progress Payment Schedules for Homeowners
- Yorgo

- 11 minutes ago
- 8 min read

A progress payment schedule sets out when your builder gets paid as work moves through defined construction stages, and the rule that matters most is simple: you only pay for work that’s finished and inspected, never in advance. Consumer Affairs Victoria, the Queensland Building and Construction Commission (QBCC) and the Domestic Building Contracts Act 1995 all anchor this principle, and Yorcon builds every contract around it.
TL;DR:
Progress payments must reflect work that has been completed and inspected, with deposits typically capped at 5–10% of the contract price.
Payments are tied to clearly defined construction stages, such as base, frame, lock-up, fixing, and practical completion, each with specific percentage ranges.
All claims should be supported by documentation like inspection certificates and photos, and paying prematurely risks voiding home warranty coverage.
Disputes over payment claims require a written response within 10 to 15 business days, and failure to respond can make the full amount payable as debt.
Negotiating a detailed, stage-specific schedule before signing and insisting on independent inspections can significantly reduce payment-related disputes.
Table of Contents
What does the law require for progress payments in Australia?
What are the standard stages in a residential building contract?
How does the payment claim and payment schedule process work?
What can you do if a builder demands payment outside the agreed schedule?
How do you negotiate a fair payment schedule before you sign?
What does the law require for progress payments in Australia?
Deposit caps exist for a reason. Most residential building contracts cap the initial deposit, and Victoria’s Domestic Building Contracts Act 1995 sets out under section 40 exactly how much a builder can claim at each defined stage, with penalties for anyone who overclaims. Other states run their own versions of this rule, so the exact percentages shift depending on where you’re building, but the underlying logic doesn’t change: what you pay should always match what’s actually been built.
The QBCC puts it plainly. For contracts over $3,300, the number and timing of progress payments gets negotiated between builder and homeowner, but every claim still has to reflect work genuinely completed, and none can push past the limits set by state home warranty insurance schemes.
Here’s what that generally looks like in practice:
Deposits are typically capped at 5–10% of the contract price, though the exact figure and any off-site work exceptions vary by state.
Progress claims must be tied to a completed stage, not a calendar date or a builder’s cash flow needs.
Parties can agree to a different schedule structure, but courts retain the power to order refunds where a builder has claimed more than the work justifies.
Pro Tip: Ask your builder for the exact percentage breakdown before you sign, not after the first invoice lands. A schedule agreed in writing upfront is far easier to enforce than one you’re trying to reconstruct mid-build.
What are the standard stages in a residential building contract?
Every state describes construction stages slightly differently, but the core sequence is consistent across industry guidance and government fact sheets. Knowing what “complete” actually means at each point protects you from paying for a stage that’s only partly done.
Base/slab: footings and slab poured, or subfloor structure finished.
Frame: wall and roof framing erected and, in most cases, passed frame inspection.
Lock-up: external walls, windows, doors and roof covering installed, so the building is weatherproof.
Fixing: kitchen, bathroom fixtures, doors, skirting and cabinetry installed.
Practical completion: the home is finished and habitable, bar minor defects.
A schedule aligned with government guidance often looks like this:
Stage | Typical percentage of contract price |
Deposit | 5–10% |
Base/slab | 10–15% |
Frame | 15% |
Lock-up | 25% |
Fixing | 20% |
Practical completion | 5–10% |
These figures are indicative, not universal, since your exact contract will set the real numbers. The one non-negotiable is proportionality: what you’re asked to pay should match what’s inspected and confirmed at that stage, never a rough estimate of “roughly there.”
How does the payment claim and payment schedule process work?
Australia’s security of payment framework (known as the BIF Act in Queensland and its state equivalents elsewhere) gives both builders and homeowners a formal structure for resolving payment disputes fast, rather than letting them drag through months of argument.
The builder issues a payment claim referencing a specific reference date, itemising the work claimed as complete.
You respond with a payment schedule, a written document stating what you intend to pay and, critically, the reasons for withholding any amount you dispute.
Response windows are typically 10 to 15 business days from the reference date, though the exact figure depends on your state’s legislation and contract terms.
If you fail to issue a payment schedule in time, you generally lose the right to dispute the claim, and the full amount can become payable as a debt.
Unresolved disputes can proceed to adjudication, which is faster and cheaper than court, though either party can still escalate to a tribunal or court later.
The QBCC’s template contract spells out these obligations clause by clause, including how progress claims should be adjusted for prime cost and provisional sum items.
What should you check before releasing any payment?
Before money changes hands, confirm the stage has actually passed inspection, not just that the builder says it has. In Victoria, a stage isn’t legitimately complete until the building surveyor’s inspection has been passed, and relying on a verbal assurance instead leaves you exposed to paying for non-compliant work.
Request the certificate of inspection or compliance certificate for that stage.
Ask for dated photos and supplier invoices for prime-cost items like tiles or appliances.
Bring in an independent building inspector if you have any doubt about progress.
Share your payment schedule with your lender early, since financiers often run their own stage valuations that can differ from the builder’s claim.
Paying ahead of schedule can also weaken your protection under home warranty insurance, which generally only covers work actually completed and paid for at the correct stage.
What can you do if a builder demands payment outside the agreed schedule?
Getting an unexpected invoice, or a demand for money before a stage is finished, is unsettling. Here’s the order of operations that protects your position.
Don’t pay on the spot. Check the claim against your contract’s defined stages and the work actually completed on site.
Issue a written payment schedule within the statutory timeframe, stating clearly which amounts you dispute and why.
Keep every piece of evidence: photos, inspection reports, emails and the original contract.
If the dispute doesn’t resolve, lodge a complaint with QBCC (Queensland) or Consumer Affairs Victoria, or pursue adjudication under the security of payment scheme.
Escalate to a tribunal or court only if adjudication doesn’t settle it.
A few things trip homeowners up here:
A verbal refusal to pay isn’t enough. Without a written schedule stating reasons, you can forfeit your right to dispute the claim entirely.
Missing the response window, even by a day, can mean the full claimed amount becomes payable as a debt.
QBCC and tribunal forms have their own strict timeframes, so act as soon as a disputed claim lands, not once it’s already overdue.
How do you negotiate a fair payment schedule before you sign?
A payment schedule is really a risk-sharing tool, not just an admin formality, and getting it right before signing saves both parties from disputes later. Homeowners can push for smaller early-stage percentages, a retention amount held back until practical completion, or an independent inspection as a condition of every claim.
Ask for retention clauses that hold back a final percentage until defects are fixed.
Fixed-price contracts generally give you more certainty on progress amounts than cost-plus arrangements, which can shift as costs change.
Watch for red flags: unusually large upfront requests, vague stage descriptions like “general progress,” or a builder unwilling to use a standard QBCC-style contract.
Clear stage definitions in the contract itself, not left to interpretation on site, are what actually prevent arguments six months in.
Yorcon’s approach to progress payment schedules

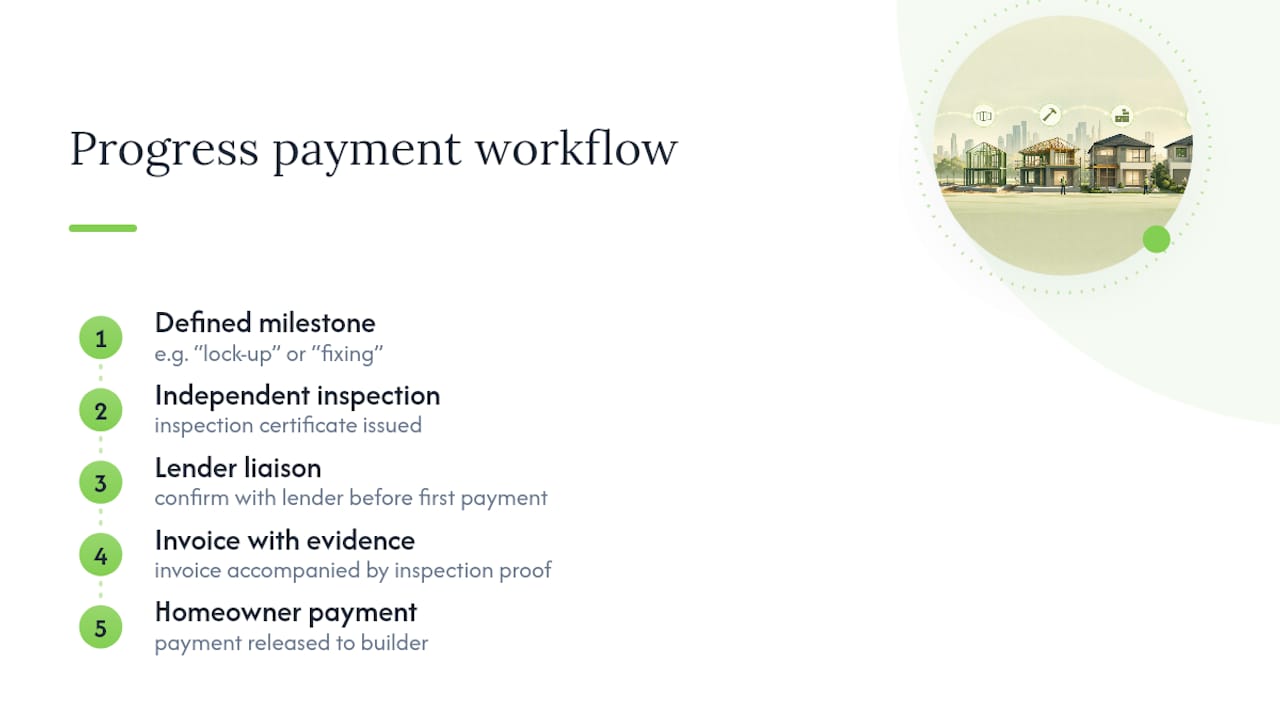

We structure every Yorcon contract around clearly defined stages, independent inspections, and direct liaison with your lender before the first payment is due. That means no ambiguity about what “lock-up” or “fixing” actually means on your project, and no invoice that arrives without evidence behind it. Our building process guide walks through exactly how stages and milestones are defined in a typical contract.

Nearly two decades of building across Melbourne has taught us that transparent invoicing, backed by inspection certificates, is what keeps a renovation or new build free of payment disputes. It’s not complicated. It just has to be done properly, every time.
How Yorcon can help you plan your build with confidence
If you’re weighing up a home extension, a full renovation, or a new architectural build in Melbourne, the payment schedule is one of the first things worth getting right, and it’s exactly where Yorcon’s fixed-price, fully managed contracts give you an edge over piecing a project together yourself. We handle design, permits, inspections and progress claims as one connected process, so you’re never left guessing whether an invoice matches the work on site.

Our home extensions and design-and-build services both come with a transparent, stage-by-stage payment structure agreed before work starts, along with independent inspections at every claim point. If you’re restoring a period property, our heritage renovation team applies the same protections to more complex, character-driven builds. Get in touch for a fixed-price quote and we’ll walk you through exactly how your progress payment schedule will work, stage by stage, before you sign anything.

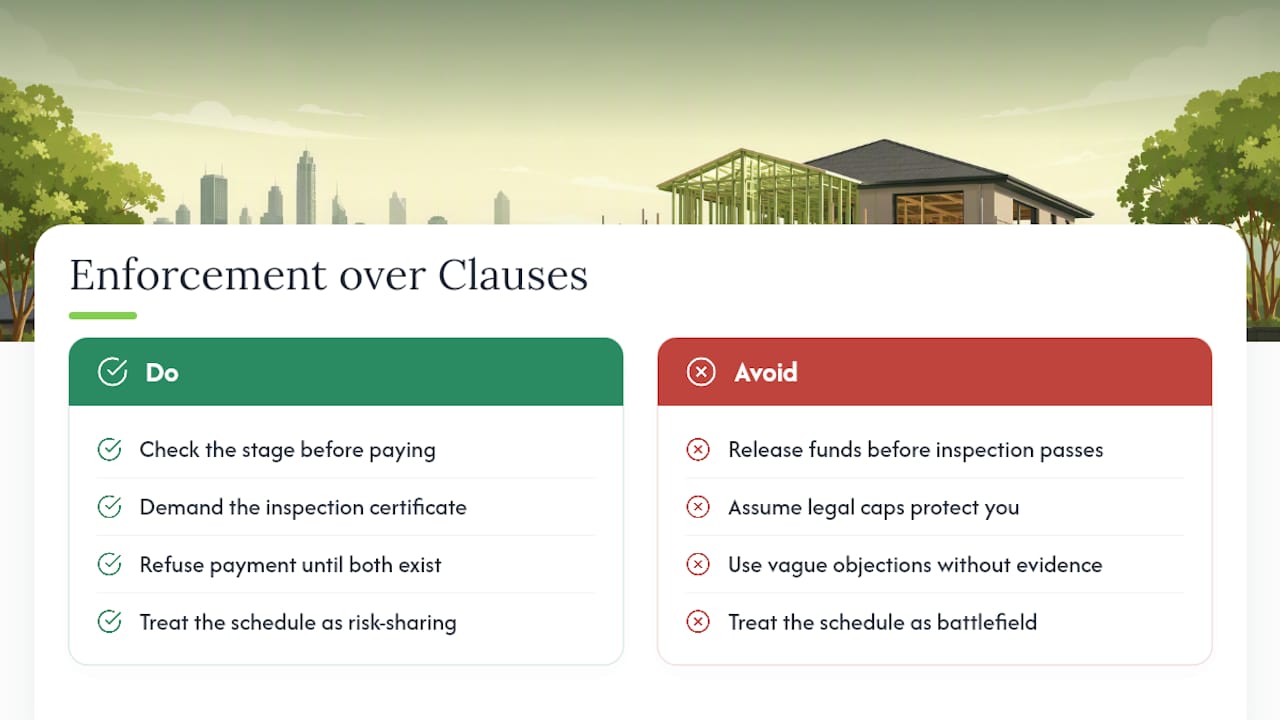

The one rule that protects you more than any clause
Every homeowner I’ve watched navigate a build eventually learns the same lesson: contracts don’t protect you, enforcement does. You can have the most carefully worded payment schedule in Australia and still get burned if you release funds before an inspection has actually passed. That’s the gap between what a good contract promises and what actually keeps your money safe.

Where I think most homeowners get it wrong is assuming the legal caps under the Domestic Building Contracts Act or QBCC rules do the protecting for them. They don’t. Those caps set a ceiling on what a builder can ask for, but nothing stops a builder from asking for that ceiling before the work justifies it. The only thing standing between you and an overclaim is your own discipline in checking the stage, demanding the certificate, and refusing to pay until both exist.
The security of payment framework cuts both ways, and that’s worth sitting with. It exists to get builders paid fairly and fast, not just to protect homeowners from dodgy claims. A payment schedule that swings too far towards withholding money, or one riddled with vague “stage not complete” objections without evidence, can leave a homeowner facing adjudication too. Fairness runs in both directions, and the contracts that work best are the ones where both sides treated the schedule as a genuine risk-sharing tool from day one, not a battlefield they’ll fight over later.
— Matthew
